Data Center & Server Room Humidity Control: When Dehumidification Is Needed and How to Select the Right System

Maintaining proper humidity in a data center or server room is just as important as controlling temperature, yet it is often overlooked until problems appear.

In many facilities, the cooling system keeps equipment temperatures within range, but moisture levels fluctuate due to outdoor air, door openings, or insufficient latent capacity. This can lead to condensation on cold surfaces, damp cable areas, or repeated humidity alarms in specific zones such as UPS rooms or air intake areas.

A dedicated data center or server room dehumidifier should be considered when humidity rises repeatedly, the cooling system cannot remove enough moisture, or condensation risk remains.

Server room dehumidifier installed beside IT equipment racks for localized moisture control.

Where Is Dedicated Dehumidification Needed in a Data Center or Server Facility?

Not every room containing IT equipment needs a separate dehumidifier.

The first step is to identify which area has the moisture problem and whether the existing cooling and ventilation system can already control it.

Signs That Additional Moisture Control Is Needed

Dedicated dehumidification deserves further review when:

  • RH or dew point rises repeatedly during humid weather.
  • Temperature reaches setpoint before enough moisture is removed.
  • Outdoor air enters through ventilation, doors, wall openings, or cable penetrations.
  • Condensation appears near chilled-water or liquid-cooling components.
  • One technical room remains humid while the main data hall is stable.
  • The existing system repeatedly overcools and reheats the air.
  • Moisture alarms occur whenever economizer or ventilation air is introduced.
  • Conditions recover slowly after doors close.
  • A local sensor appears normal while a colder or poorly ventilated zone remains damp.

Data Center Areas and Typical Dehumidification Approaches

Data Center AreaTypical Moisture ProblemCheck FirstLikely Dehumidification Approach
Main data hallHigh dew point or unstable humidity across the hallCRAC/CRAH sequence, outdoor-air treatment, and sensor layoutIntegrate moisture control with the central HVAC system
Outdoor-air intakeDew point rises whenever ventilation or economizer air entersOutdoor design condition and airflow volumePretreat the outdoor air before it reaches the data hall
Edge or modular data centerFrequent door opening and direct outdoor exposureInfiltration, pressure, and limited HVAC moisture controlStandalone or compact ducted dehumidifier
Small server roomSplit AC controls temperature but not humidityActual latent capacity of the cooling unitLocal refrigerant or ducted dehumidifier
MDF, IDF, or network roomHigh RH near an exterior wall or service entranceDoor seals, penetrations, and adjacent-space conditionsSeal leakage and add local moisture control if needed
UPS or electrical roomHumid ventilation air or damp surfacesAir exchange rate and connection to the main HVAC systemIndependent or ducted dehumidification
Cable or underground roomSeasonal dampness, wall moisture, or humid tunnel airWaterproofing, drainage, and air leakageCorrect liquid-water entry, then control the remaining vapor load
Post-leak areaWet materials and rapidly rising dew pointConfirm that the active leak has stoppedTemporary drying rather than permanent operating capacity

Battery rooms require a separate safety review because ventilation, gas detection, electrical requirements, and battery chemistry may take priority over humidity control.

A dehumidifier removes water vapor. It does not repair a roof leak, replace failed insulation, stop groundwater penetration, or seal an uncontrolled opening.

What Humidity and Dew Point Should a Data Center or Server Room Maintain?

There is no universal rule that every server room should be maintained at 45% RH.

The target condition depends on:

  • IT equipment class
  • Room and inlet-air temperature
  • Coldest exposed surface temperature
  • Equipment manufacturer requirements
  • Contamination and corrosion risk
  • ESD-control procedures
  • Sensor location and accuracy

Use the Recommended Envelope as the Normal Operating Target

ASHRAE separates recommended conditions from allowable conditions.

The recommended envelope is the normal design and operating target. The allowable envelope represents broader conditions in which qualifying equipment may operate, but it should not automatically become the permanent setpoint.

For air-cooled Classes A1 through A4, the current ASHRAE TC 9.9 reference card lists:

  • Recommended inlet temperature: 18°C to 27°C
  • Recommended lower moisture limit: −9°C dew point
  • Recommended upper moisture limit: 15°C dew point

The upper RH condition depends on measured silver and copper corrosion levels.

Do not use 70% RH as a default data center or server room setpoint. That expanded upper boundary applies only under defined corrosion conditions and does not replace manufacturer requirements or a project-specific operating target.

The selected condition should leave enough margin between the room dew point and the coldest exposed surface. It should also avoid an unnecessarily narrow control band that causes humidification, cooling, and dehumidification systems to cycle against each other.

Why Dew Point Matters More Than a Single RH Reading

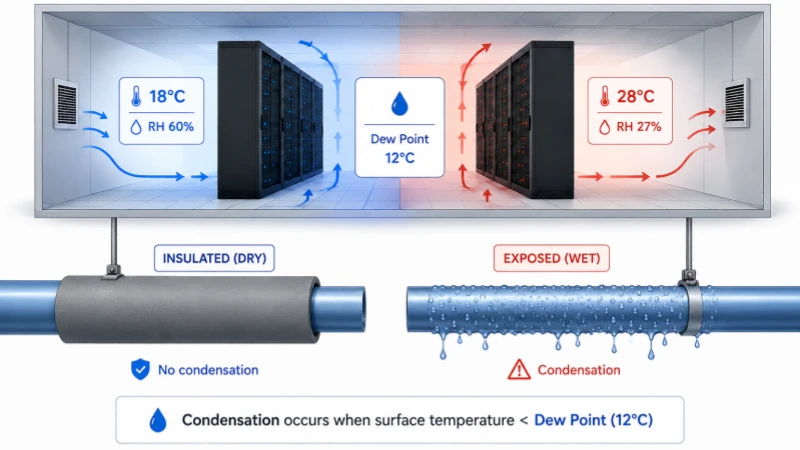

Data center dew point diagram comparing aisle RH and chilled-pipe condensation risk.

Relative humidity changes when temperature changes.

Air containing the same amount of water vapor can show higher RH in a cold aisle and lower RH in a warm return-air zone. The actual moisture content has not necessarily changed.

Dew point gives a more stable indication of the amount of water vapor in the air. ASHRAE’s data center environmental guidance notes that dew point remains relatively consistent across a room while RH can vary with local temperature.

Condensation becomes possible when a surface temperature falls below the surrounding dew point.

For example:

  • Room dew point: 14°C
  • Properly insulated pipe surface: 17°C
  • Immediate condensation risk: low

If damaged insulation exposes a pipe surface at 10°C, the surface may begin to sweat because it is colder than the room dew point.

Lowering room moisture can reduce the risk, but it does not replace repairing insulation, removing a cold bridge, or reviewing coolant temperature.

Three common patterns help explain what the readings mean:

  • RH rises while dew point remains stable: the local air probably became colder.
  • Dew point rises across several sensors: additional moisture is entering the facility.
  • Average RH looks normal while one surface sweats: the local surface is colder than the room-average condition suggests.

Where Does Moisture Enter a Data Center or Server Room?

Servers produce sensible heat. They are not normally the main source of water vapor.

Moisture usually enters with outdoor air, moves from an adjacent space, or evaporates from wet building materials.

Humid Outdoor Air and Economizer Operation

Outdoor air may enter through:

  • Mechanical ventilation
  • Economizer operation
  • Open service doors
  • Damaged door seals
  • Cable and wall penetrations
  • Service ducts
  • Negative room pressure
  • Loading or maintenance areas

Even a relatively small airflow can create a large continuous moisture load when the outdoor humidity ratio is high.

Where ventilation or economizer air is the dominant source, treating the air before it enters the data hall is often more effective than placing a standalone unit in the middle of the room.

Door Opening and Edge-Site Infiltration

Edge and modular data centers are often located closer to exterior conditions and may experience frequent maintenance access.

A rapid dew-point rise after a door-opening event may indicate:

  • Damaged seals
  • Excessive opening duration
  • Negative room pressure
  • No vestibule or airlock
  • Insufficient moisture-removal capacity

The first actions may include sealing leakage, adjusting room pressure, reducing opening time, or adding a vestibule. The dehumidifier should then be sized for the moisture load that remains.

Adjacent and Underground Technical Spaces

A server room beside a warehouse, production area, basement corridor, cable tunnel, or utility space may receive moisture whenever doors open or pressure changes.

Measure conditions on both sides of the boundary. A normal reading in the middle of the server room does not show how much moisture is entering through a wall opening or cable penetration.

Underground areas also require checks for:

  • Damp concrete
  • Wall seepage
  • Groundwater pressure
  • Failed waterproofing
  • Poor drainage
  • Humid service tunnels

Where liquid water is present, repair the building problem before using a dehumidifier as a permanent compensating measure.

Temporary Moisture From Construction, Cleaning, or Leaks

Concrete, floor coatings, wet insulation, recently painted surfaces, and cleaning water may release moisture for hours or days.

Temporary drying may be required during commissioning or after repair work, but that short-term load should not automatically determine the capacity of the permanent dehumidification system.

Hidden moisture may remain:

  • Below raised floors
  • Inside wall cavities
  • Behind insulation
  • Around cable penetrations
  • Beneath floor finishes

Track dew point and inspect the affected materials instead of ending recovery as soon as the visible floor appears dry.

Which Type of Dehumidifier Fits a Data Center or Server Room?

The correct technology depends on:

  • Room temperature
  • Target dew point
  • Moisture load
  • Airflow arrangement
  • Outdoor-air volume
  • Drainage
  • Control requirements
  • Heat added to the room

The practical differences between refrigerant and desiccant dehumidifiers become meaningful only when the equipment is compared at the actual project condition.

When a Refrigerant Dehumidifier Fits

Data center dehumidifier positioned beside server racks with overhead ducted airflow.

A refrigerant dehumidifier cools air below its dew point, condenses water, and returns drier air.

It is often suitable for:

  • Warm server rooms
  • Edge computing rooms
  • Telecom and network rooms
  • UPS and electrical spaces
  • Moderate or high moisture loads
  • Applications without a very low dew-point target

Its capacity normally decreases as entering air becomes cooler or drier.

A standalone refrigerant unit also adds sensible heat to the room. Compressor power and the heat released during condensation return to the airstream.

Confirm:

  • Capacity at the actual room temperature and RH
  • Heat added to the space
  • Whether the cooling system can remove that heat
  • Condensate drainage
  • Partial-load control
  • Alarm and communication requirements

Where combined temperature and moisture control is required within one packaged system, a temperature-controlled dehumidifier may be more appropriate than adding an independent room unit.

When a Desiccant Dehumidifier Fits

A desiccant dehumidifier transfers moisture to a drying material and removes it through a regeneration airstream.

It may be more suitable when:

  • The room operates at a lower temperature.
  • A lower dew point is required.
  • Humid outdoor air requires pretreatment.
  • Refrigerant performance becomes limited.
  • The process requires stable low-moisture air across changing loads.

Desiccant process air is warmer unless post-cooling is provided.

The project must account for:

  • Regeneration energy
  • Process-air temperature
  • Regeneration or exhaust airflow
  • Ducting
  • Heat rejection
  • Post-cooling
  • Control integration

When to Use a Ducted or HVAC-Integrated System

A ducted or integrated system may fit when:

  • The main data hall requires coordinated central humidity control.
  • Outdoor ventilation air needs pretreatment.
  • One unit serves several technical rooms.
  • Dry air must reach a specific risk zone.
  • A floor-standing unit would disturb rack airflow.
  • Heat needs to be managed outside the controlled room.
  • Central alarms and interlocks are required.

A shared system can serve several spaces only when airflow, pressure, sensor authority, and control priority are designed for each zone.

A free-standing unit in one closed room should not be expected to control adjacent spaces.

When a Portable Dehumidifier Is Appropriate

Portable equipment may be suitable for:

  • Commissioning
  • Short-term seasonal problems
  • Post-leak drying
  • A small noncritical technical room

Leaving a portable unit in an unattended server room requires:

  • Continuous drainage
  • Pump-failure alarm where applicable
  • High-water shutdown
  • Automatic restart
  • Remote fault output
  • Suitable electrical protection
  • Capacity at the actual room condition

A household unit that stops when a small collection bucket fills is not a reliable permanent solution for a critical space.

Do Not Compare Dehumidifiers by L/Day Alone

SolutionBest FitMain LimitationHeat EffectCheck Before Selection
Standalone refrigerantWarm server rooms and local technical spacesLower output in cooler or drier airUsually adds heat directly to the roomActual-condition capacity and cooling impact
Ducted refrigerantControlled distribution and multiple zonesMore installation workHeat can be managed through the system designSupply, return, drainage, and heat rejection
DesiccantLower temperature, lower dew point, or outdoor-air treatmentRegeneration energyProcess air is warmer unless post-cooledDew point, regeneration source, and post-cooling
HVAC-integratedMain data halls and central outdoor-air treatmentControl complexityDepends on system arrangementBMS sequence, interlocks, and total HVAC load
PortableTemporary drying or noncritical roomsLimited alarms and distributionUsually adds heat locallyDrainage and unattended-operation features

How Much Dehumidification Capacity Is Required?

Room size is only one input.

Two rooms with identical dimensions can need very different capacities if one is sealed inside a conditioned office and the other opens into a humid loading area.

Estimate the Moisture Load Before Comparing Models

Required capacity is mainly affected by:

  • Mechanical outdoor-air volume
  • Uncontrolled infiltration
  • Door-opening frequency
  • Difference between incoming and target moisture levels
  • Moisture released from wet materials
  • Required recovery time

A complete industrial dehumidifier sizing method should also account for actual rating conditions, equipment heat output, peak events, partial-load behaviour, and a suitable allowance.

Check Capacity at the Actual Room Condition

Before accepting a capacity claim, confirm:

  • Entering-air temperature
  • Entering-air RH
  • Moisture-removal output at that condition
  • Defrost behaviour
  • Sensible heat added to the room
  • Airflow
  • Available external static pressure
  • Test data supporting the rating

A unit rated at 100 L/day under warm, humid test conditions may remove much less water inside a cooler server room.

Avoid Oversizing and Decide Whether Redundancy Is Needed

An undersized unit may run continuously without reaching the target.

A severely oversized fixed-capacity unit may satisfy the nearest sensor too quickly, short-cycle, and leave remote areas humid. These over- and undersizing problems can increase wear and destabilize the control sequence.

Where the moisture load changes significantly, consider:

  • Staged capacity
  • Modulating control
  • Lead-lag operation
  • Several smaller units serving separate zones

Redundancy becomes more reasonable when:

  • The space is unattended.
  • Moisture control is mission-critical.
  • Repair support is slow.
  • Outdoor moisture enters continuously.
  • Maintenance must occur without losing control.

How Should the Dehumidifier Be Installed and Controlled?

Correct capacity cannot compensate for poor air distribution, unsafe drainage, or conflicting controls.

Place the Unit Without Disturbing Rack Cooling

The unit should sample representative room air and distribute dry air without disrupting the designed cooling path.

Avoid:

  • Blowing directly into server exhaust
  • Pulling air away from a cold aisle
  • Returning dry air directly to the unit inlet
  • Blocking rack or electrical-panel access
  • Servicing the unit above live equipment
  • Installing it beneath a known leak risk
  • Routing condensate above servers or power equipment

For ducted systems, define the supply and return locations. Dry air delivered to the wrong part of the room may satisfy the unit sensor while leaving the actual moisture source untreated.

Install Sensors Near the Areas Most Likely to Change

A sensor inside the dehumidifier may not represent conditions behind racks, beside an exterior door, near an outdoor-air intake, or next to a cold pipe.

Useful locations include:

  • IT equipment air inlets
  • Return-air paths
  • Outdoor-air entry zones
  • Exterior doors
  • Cable penetrations
  • Underground or exterior walls
  • Chilled-water and liquid-cooling connections
  • UPS and electrical rooms
  • Previous condensation locations

Avoid relying only on a sensor in a supply-air jet, above a drain pan, or against a cold wall.

Plan Safe Condensate Drainage and Leak Protection

A refrigerant dehumidifier converts water vapor into liquid water.

A suitable drainage arrangement may include:

  • Continuous gravity drain
  • Correct pipe slope
  • Drain trap where required
  • Condensate pump with failure alarm
  • Secondary drain pan
  • High-water shutdown
  • Leak-detection sensor
  • Accessible cleanout
  • Drain routing away from IT equipment

Test the drain, pump, alarm, and shutdown during commissioning. A connected hose does not confirm that water can discharge safely under all conditions.

Coordinate the Dehumidifier With the Existing HVAC System

The control sequence should define:

  • RH or dew-point setpoint
  • Deadband
  • Authoritative sensor
  • High- and low-humidity alarms
  • Drain and pump alarms
  • Automatic restart after power loss
  • Remote enable and disable
  • Common fault output
  • BMS or DCIM communication
  • Lead-lag logic
  • Response when sensors disagree

A narrow deadband can cause rapid cycling. Two systems using different sensors may alternately dehumidify and humidify the space.

Filters, coils, sensors, drains, alarms, and airflow should be included in the site’s industrial dehumidifier maintenance checklist.

What Information Is Needed for an Accurate Selection?

A reliable proposal requires more than room area and a target RH.

Information GroupDetails to PrepareWhy It Matters
Controlled areaMain data hall, edge room, server room, UPS room, cable room, or outdoor-air intakeDetermines the system arrangement
Room conditionsDimensions, current temperature and RH, target RH or dew pointDefines the required environment
Outdoor conditionsDesign temperature, humidity, and outdoor-air volumeDetermines incoming moisture load
Moisture sourcesDoors, penetrations, adjacent spaces, ventilation, and wet materialsSeparates continuous and temporary loads
Existing HVACCRAC, CRAH, split AC, economizer, ventilation, and current controlsIdentifies control gaps and conflicts
Cold surfacesPipe, coolant, fitting, coil, and diffuser temperaturesDefines condensation margin
InstallationAvailable space, duct route, drainage, and electrical supplyDetermines equipment format
Heat impactExisting cooling capacity and acceptable additional heat loadConfirms whether unit heat can be removed
MonitoringSensor locations, alarms, BMS/DCIM protocol, and auto restartDefines unattended-operation capability
PerformanceRecovery time, actual-condition capacity, airflow, and noise limitAllows quotations to be compared correctly
ReliabilityRedundancy, service access, spare parts, and maintenance planDefines the required system arrangement
Special risksBattery rooms, contaminants, gas risk, or electrical classificationPrevents an unsuitable installation

A supplier should identify missing information rather than selecting a model from room area alone.

With these inputs, the project team can:

  1. Identify the main moisture source.
  2. Decide whether moisture should be controlled locally or at the outdoor-air system.
  3. Estimate the required removal load.
  4. Check whether the existing cooling system can handle the added heat.
  5. Compare refrigerant, desiccant, standalone, ducted, and integrated solutions.
  6. Define drainage, sensors, alarms, and control integration.
  7. Verify capacity at the actual operating condition.

Send Rinwang the controlled area, room temperature, current RH, target dew point or RH, outdoor-air volume, door-opening pattern, cold-surface temperatures, drainage conditions, and existing HVAC information.

Based on those inputs, Rinwang can review the moisture source, estimate the required removal load, and recommend an industrial dehumidifier configuration with capacity, airflow, drainage, controls, and heat impact matched to the data center or server room conditions.

Frequently Asked Questions

What happens if the humidity is too low in a data center?

Low humidity increases electrostatic-discharge risk during maintenance or equipment handling. Control should combine an appropriate moisture limit with grounding and ESD procedures.

Do all data centers follow ASHRAE?

No. Many use ASHRAE as a design baseline, but final operating limits depend on equipment specifications, facility design, risk tolerance, and local requirements.

Can tropical countries follow these standards?

Yes. ASHRAE targets remain applicable, but tropical facilities may require stronger outdoor-air pretreatment, tighter infiltration control, and greater dehumidification capacity.

Should a dehumidifier run all the time?

Not necessarily. It should remain available continuously but cycle according to dew point or RH demand; nonstop moisture removal may indicate undersizing or uncontrolled infiltration.

Can a dehumidifier replace an air conditioner?

No. A dehumidifier removes moisture and usually adds heat, while air conditioning removes the server room’s sensible heat load; both systems may need coordinated operation.

Production Director

Hi, I’m Hao, (the production director of rinwang.com), hope you like this article

With more than 12 years of experience in dehumidifiers, I’d love to share with you the valuable knowledge from a Chinese supplier’s perspective.

I am looking forward to talking with you about your ideas and thoughts.

Table of Contents

Related Post

Water damage does not stop at the floor surface. Once moisture enters walls, insulation, subfloors, hardwood, or concrete, cleanup turns into structural drying. EPA guidance notes that many wet materials should be dried within 24 to 48 hours to help reduce mold risk. That is why restoration teams usually need faster and more controlled drying […]

In electronics manufacturing, humidity problems rarely arrive as one obvious failure. They usually show up as smaller warnings across the factory: soldering results that drift more than expected, moisture-sensitive parts waiting too long outside controlled storage, packaging that feels damp near dispatch, or production zones that behave differently from one shift to the next. In […]

Excess moisture affects different industrial environments in unique ways. In this guide, we break down how industrial dehumidifiers are applied across various settings – from vast warehouses to damp crawl spaces – and what to consider in each scenario. (If you need a primer on industrial dehumidifier basics, see our [ Complete Guide to Industrial […]

Contact Us Today, Get Reply Tomorrow

Your information will be kept strictly confidential.

Ruiwang employees and clients at a trade show.

Our team would be happy to meet you and learn all about your business, requirements and expectations.
